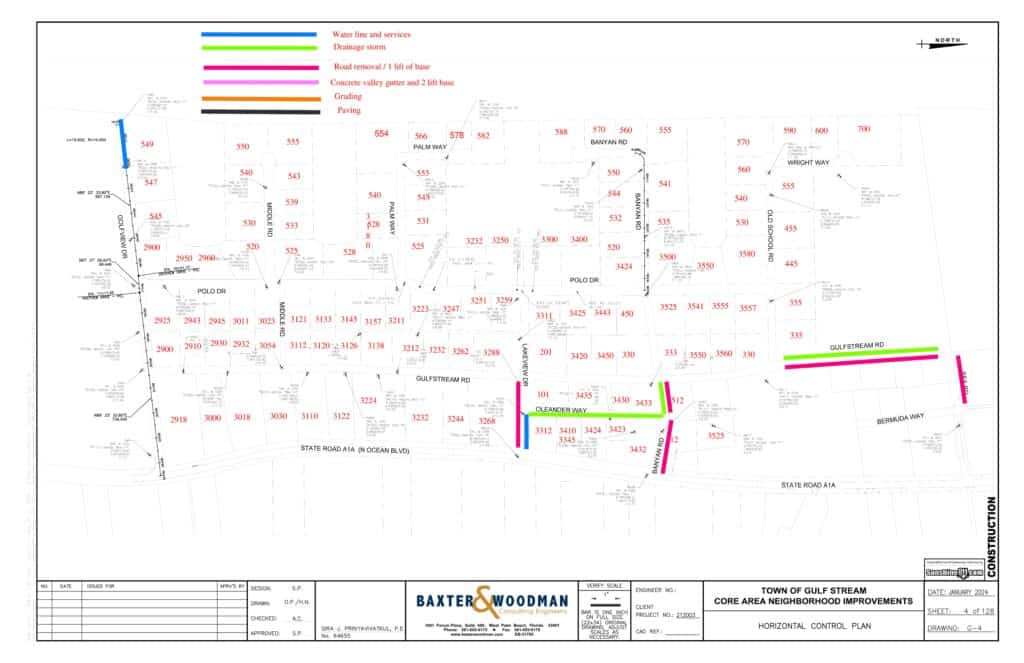

Notification of planned construction activity for 09/01/25 thru 09/07/25:

Roadway Construction plans to perform the following work activities:

  • Remove road, install the 1st lift of base, and conduct storm drainage work on Gulfstream Road.
  • Remove road and install the 1st lift of base on Sea Road between Gulfstream Road and Bermuda Way.
  • Remove road, install the 1st lift of base, and conduct storm drainage work on Banyan Road between A1A and Gulfstream Road.
  • Install storm drainage on Oleander Way between Lakeview Drive and Banyan Road.
  • Remove road, install the 1st lift of base, and install water line and services on Lakeview Drive between A1A and Gulfstream Road.
  • Install waterline and services on Golfview Drive East of Gulfstream Road.

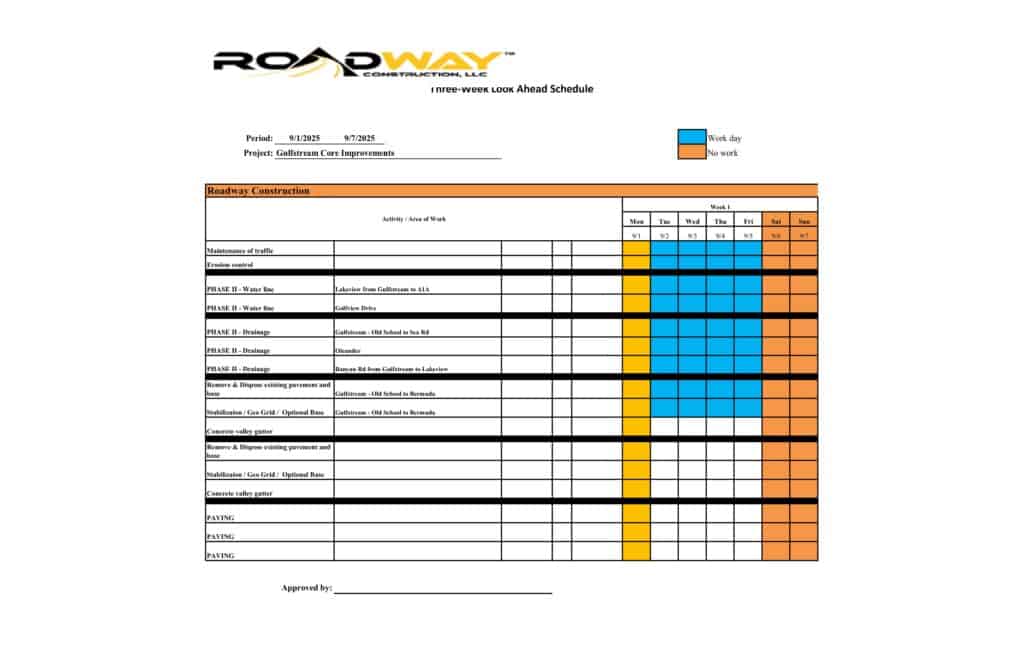

Contractor Work Schedule 9/01 - 9/07
